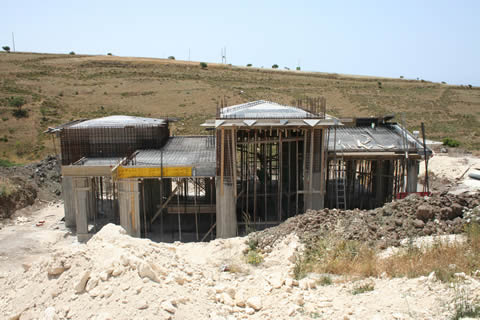

4 May 2008

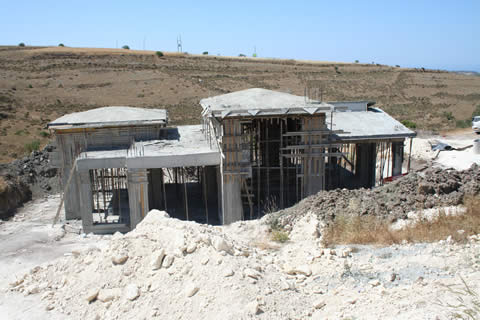

Working at the weekend constructing the shuttering for the roofs and
ceilings.
There are 4 separate roof profiles including one section of flat roofing
which will house the air conditioning units plus the hot water tank and
solar panels. The other 3 sections are tiled.
The roofs / ceilings are solid re-inforced concrete just like the floors.
|
|
|

|
|
4 May 2008

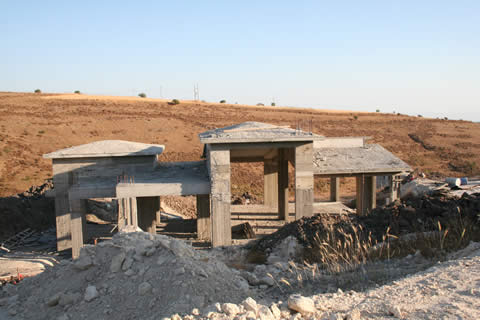

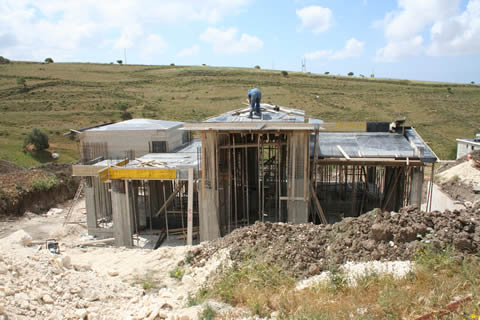

From a different angle
|
|
|

|
|
4 May 2008

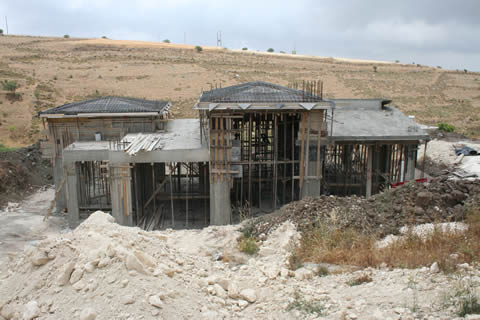

From the rear. This looks more substantial because the walls of the basement
are still on view at this side.
|
|
|

|
|
4 May 2008

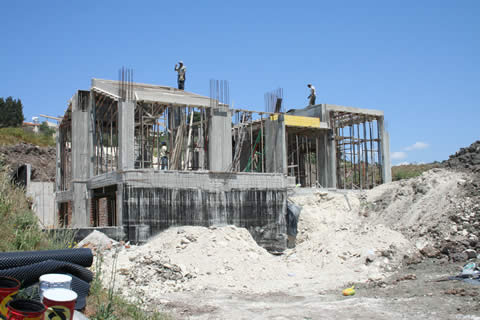

Starting to construct the walls in the basement.
|
|
|

|
|
4 May 2008

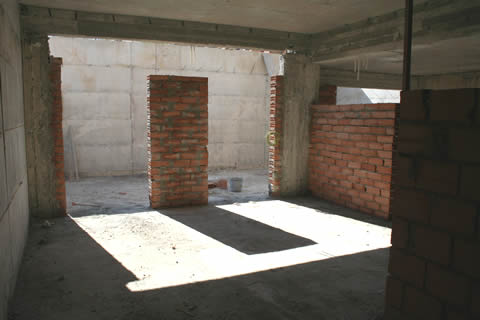

From inside the basement
|
|
|

|
|
9 May 2008

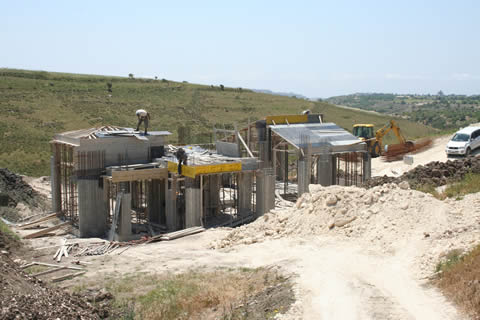

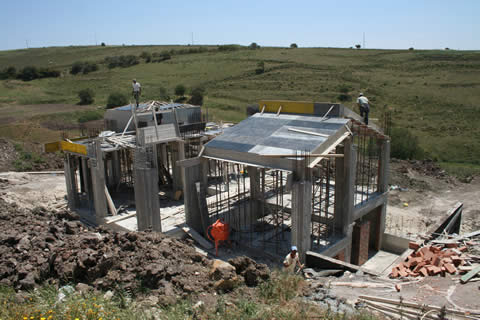

Progress.
The tallest structure where the builder is standing on the roof will be
clad in stone and has archways to 2 sides leading to the front door. The
rest of the bungalow will be rendered and painted.
|
|
|

|
|
9 May 2008

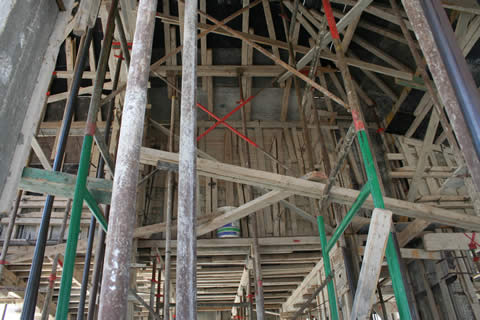

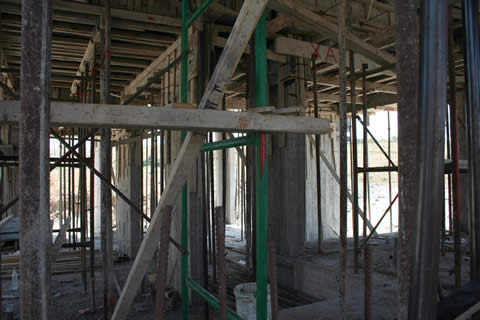

Extent of scaffolding inside to hold up roof shuttering.
|
|
|

|
|
22 May 2008

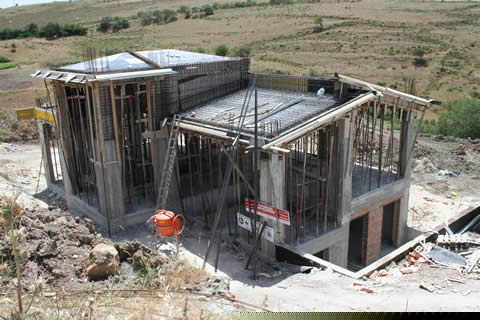

Progress has slowed down again with the roof shuttering and the steel
work. All roof concreting was due to be finished today.
|
|
|

|
|
22 May 2008
Completion of 3 roofs is now due on Tuesday 27th May and the other 2
roofs on Friday 30th.
The full 'skeleton' of the building should therefore be finished by the
end of May and the brickwork should follow immediately. (At least that's
the plan, we have our fingers crossed!!)
|
|
|

|
|
29 May 2008

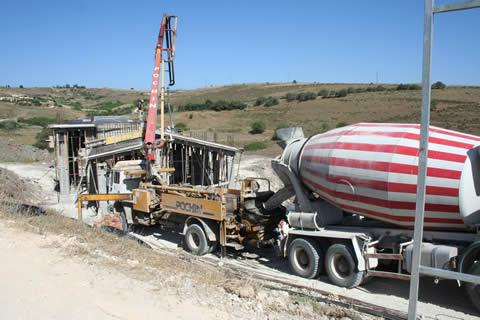

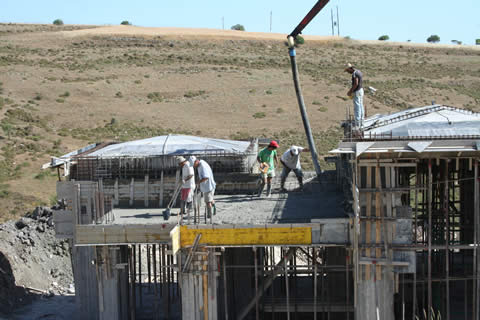

1 flat roof and 2 sloping roofs being concreted today. It is a very dry
mix used on roofs but still supplied via the pump.
|
|
|

|
|
29 May 2008
The flat roof sections
|
|
|

|
|
29 May 2008

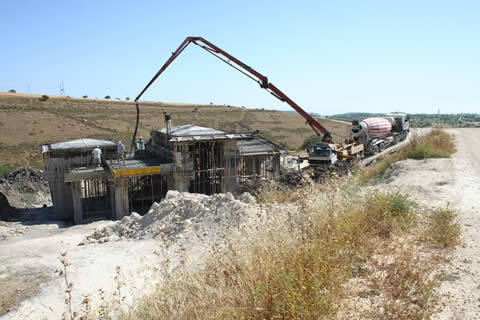

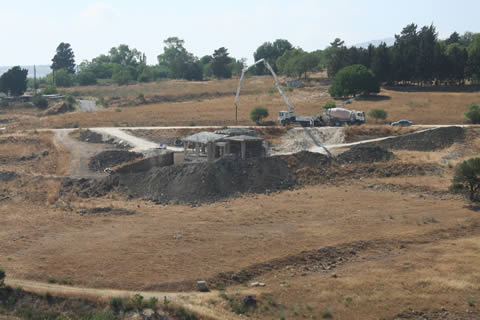

From cement lorry to crane-pump to the workplace. 3 seperate deliveries
supplied todays concrete.
|
|
|

|
|
29 May 2008

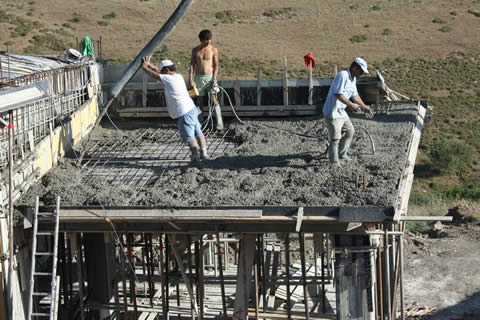

The last sloping roof being poured.
The whole operation took place late in the day, we guess to prevent the
hot sun drying it out too quickly, it was a hot day today.
|
|
|

|
|
1 June 2008

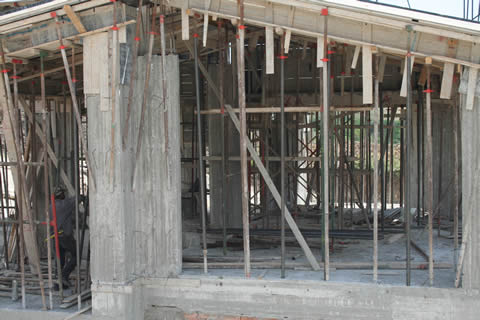

Showing the complications of the shuttering for the roofs.
|
|
|

|
|
1 June 2008
and the extent of the scaffolding to hold the weight of the concrete
above.
|
|
|

|
|
6 June 2008
Steel work completed on the last 2 roof sections, ready for concrete.
Shuttering has been removed from the flat roof sections and the sloping
roof sections.
|
|
|

|
|
6 June 2008
When the concrete has dried the roof is made waterproof (believed by
painting with bituman) and then tiled with conventional roof tiles.
|
|
|

|
|
10 June 2008
Concreting the last two roof sections.
|
|
|

|
|
13 June 2008

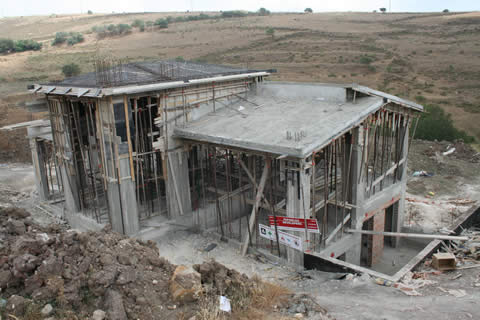

All roof concrete done.
Skeleton finished.
Internal and external brickwork next, as soon as the concrete is strong
enough for the scaffolding and acrows to be removed, which is about 2
weeks.
|
|
|

|
|
30 June 2008
Shuttering and supports removed.

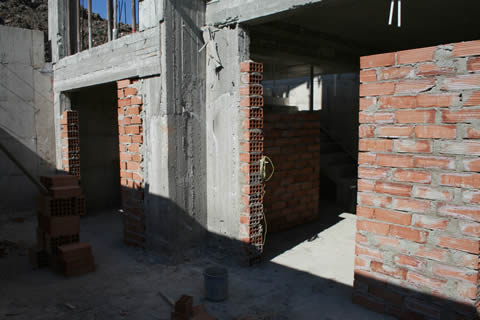

Brick work next.
|
|
|
|
|
Next Page Jul - Sep 08 |
|
|
|
|
|
|
 |
 |
 |
 |
 |
