10 October 2008
Finishing coats of rendering on outside.
|
|
|

|
|
10 October 2008

More shuttering at end of veranda for retaining wall for the veranda
base.
|
|
|

|
|
10 October 2008

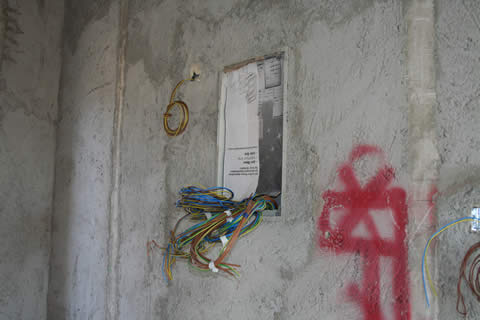

Main fuse panel in lobby.
|
|
|

|
|
10 October 2008

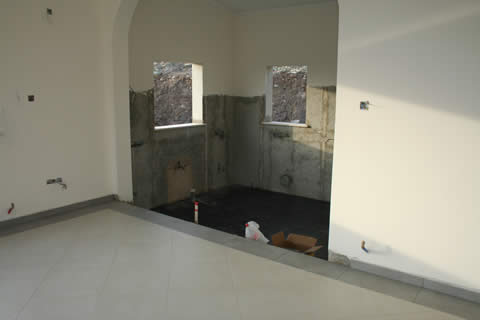

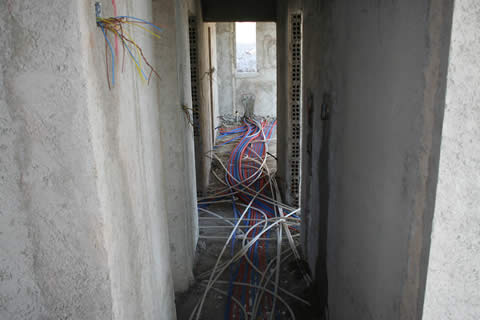

All services now in. Electrical wiring completed and water pipes tested.
Next is the laying of approx 6" of foam concrete over the whole
floor area.
|
|
|

|
|
17 October 2008

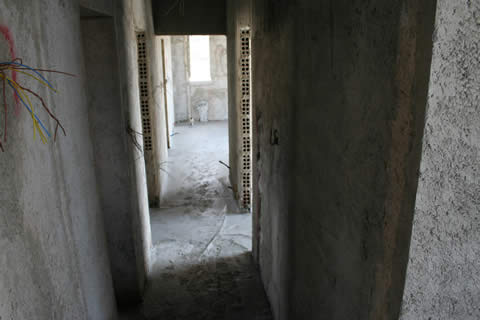

All floors covered with foam concrete.
|
|
|

|
|
Some of the plaques being inset into
the walls of the bungalow
|
|
|

|
|
24 October 2008

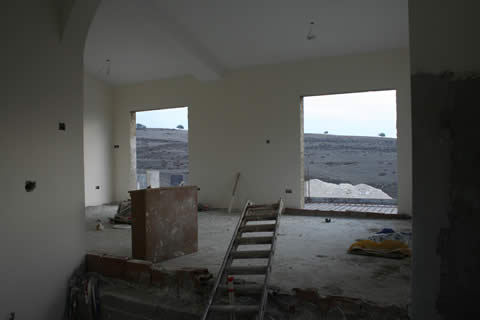

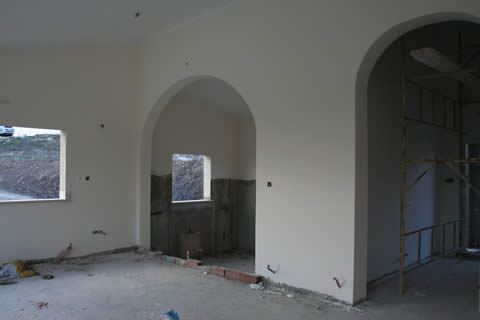

First coats of plaster completed in all rooms. This picture taken in
the lounge.
The plastering should be finished in 1 week and then tiling will start
on the floors. Tiles for all rooms have been chosen and ordered along
with windows, and granite work tops for the kitchen.
|
|
|

|
|
24 October 2008
Preparing for verandas at the rear. The one outside the lounge is covered,
with steps down to the other. Further steps lead down to the swimming
pool where you can see the break in the retaining wall. The veranda floors
should be laid in the next week and then the swimming pool will be excavated.
|
|
|

|
|
31 October 2008

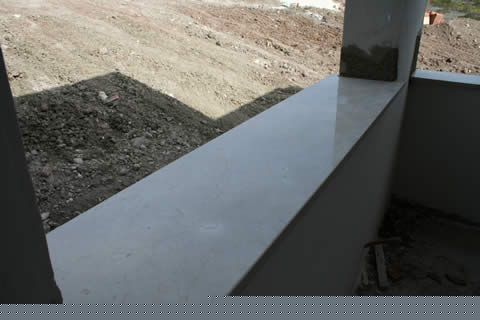

Marble window sills fitted.
|
|
|

|
|
2 November 2008

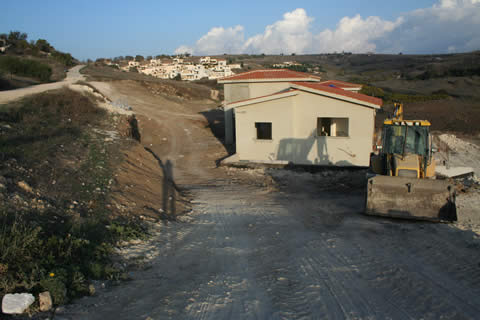

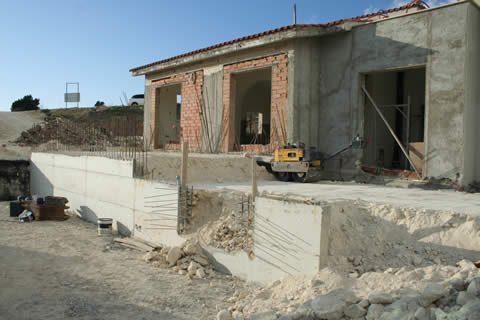

Groundworks at the front.
Drives and levels in front of house.
|
|
|

|
|
2 November 2008

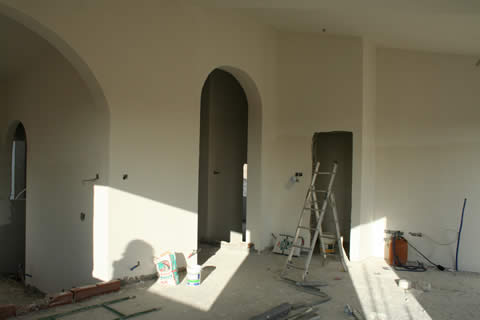

Plastering and first coat of paint finished in nearly all the rooms on
the ground floor.
|
|
|

|
|
5 November 2008

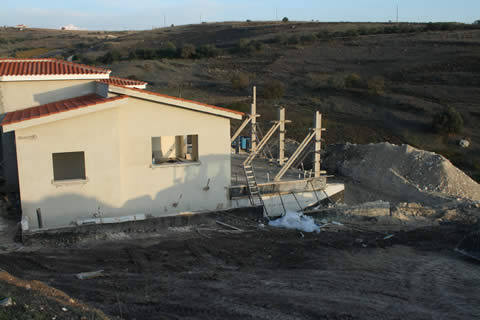

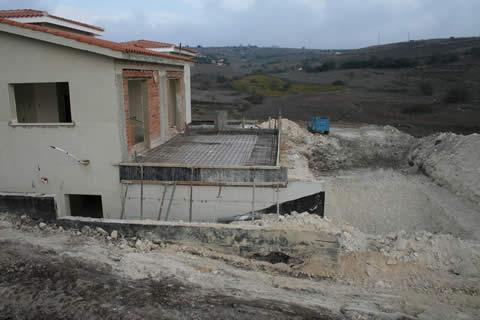

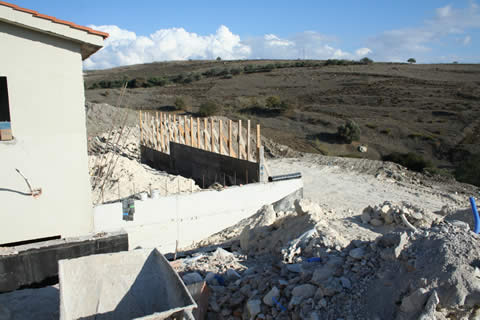

Shuttering for main veranda at rear.
|
|
|

|
|

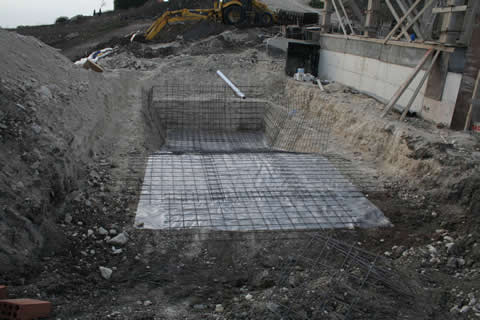

5 November 2008

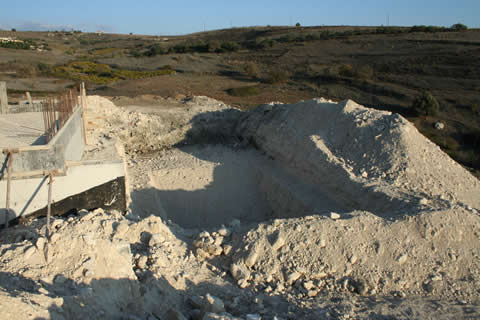

Excavation for the swimming pool. The swimming pool is not built using
shuttering, it is constructed using pre-built metal frames.
|
|
|

|
|
5 November 2008

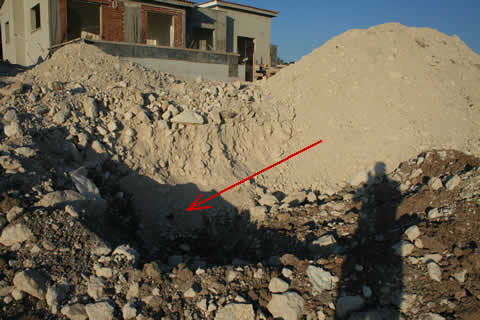

The arrow points to the main sewerage pipe from the house. The cutting
edge sceptic tank will be built here. We are also hoping to install a
system that re-cycles 100% of grey water that can be used for cleaning
cars, topping up the pool and irrigating the garden. This is expected
to be compulsory in Cyprus within a couple of years and sounds a very
good idea to us.
|
|
|

|
|
8 November 2008

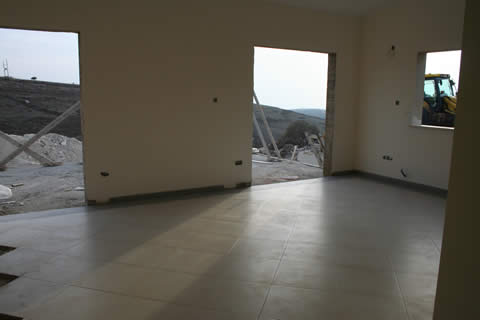

The lounge from the kitchen.
The plastering is finished internally and we are now waiting for the
tiler to start tiling all the floors.
|
|
|

|
|
8 November 2008

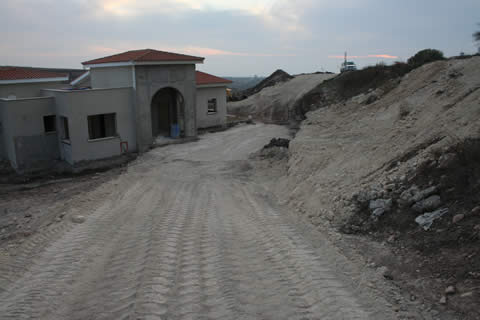

Drive in and out. Stamped concrete will be used in front of the house.
|
|
|

|
|
8 November 2008

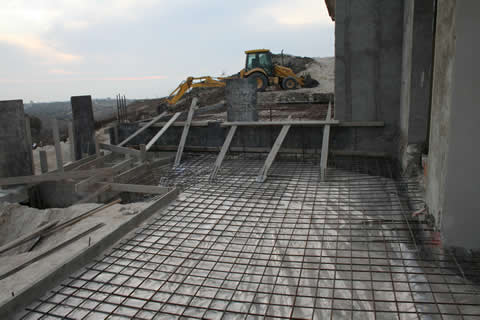

Steel reinforcing completed for the verandas.
|
|
|

|
|
8 November 2008
Smaller veranda at the rear outside the office and bedroom.
|
|
|

|
|
14 November 2008
Veranda concreted and shuttering done for the columns which will support
the roof of the covered veranda.
|
|
|
|
|
14 November 2008

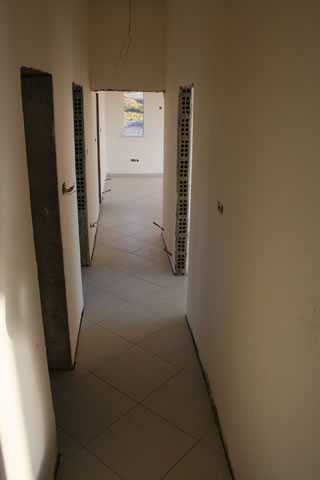

Tiling laid in bedrooms, office and passage.
|
|
|

|
|
14 November 2008
Tiling laid in Master Bedroom.
|
|
|

|
|
18 November 2008

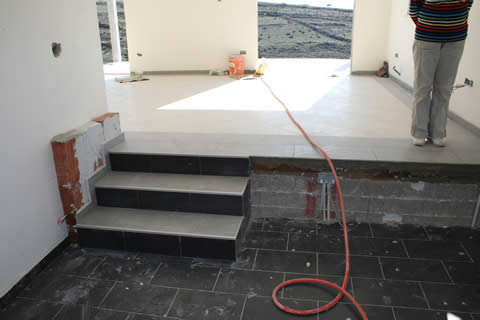

Tiling in lounge.
When all the tiling is completed, the doors and windows can be measured
and ordered.
|
|
|

|
|
18 November 2008
Lounge and kitchen. Kitchen tiles are black in colour. A breakfast bar
will separate the kitchen.
|
|
|

|
|

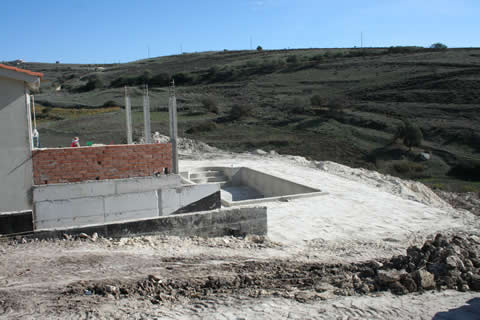

18 November 2008

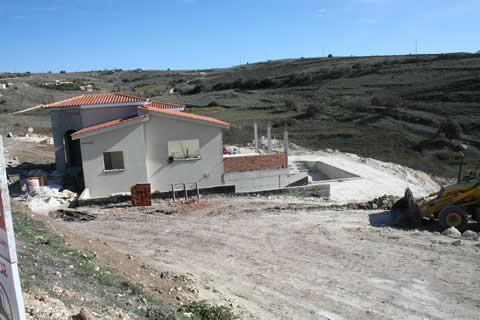

Start of the construction of the pool. All the fabrication panels have
been delivered so the construction should not take too long.
|
|
|

|
|
21 November 2008

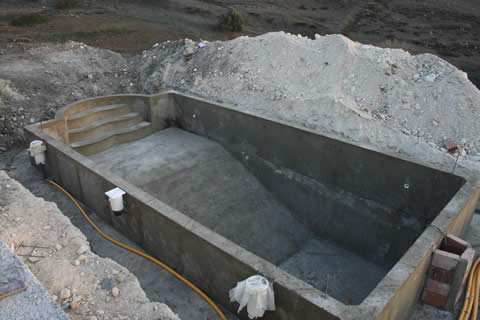

Swimming pool cast in concrete from a metal frame which gives the walls
a very smooth finish.
|
|
|

|
|
21 November 2008

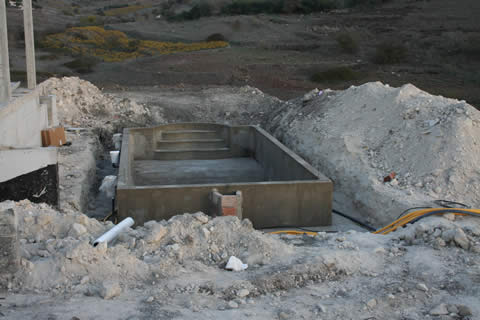

The steps are a nice shape but the pool looks deeper than it should be
at the deep end. Maybe there is more infilling to do at the bottom.
|
|
|

|
|
21 November 2008

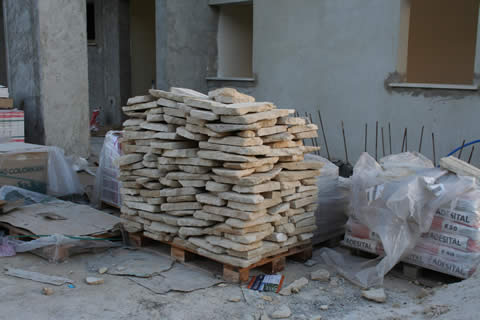

The stone has been delivered for the facing of the walls around the porch.
|
|
|

|
|
29 November 2008
Ground levelling at rear and compressed with crushed stone ready for
shuttering and concrete.
|
|
|

|
|
29 November 2008
Small wall at one end of the covered veranda. Against the wall inside
will be a barbecue with kitchen units either side.
|
|
|

|
|
29 November 2008

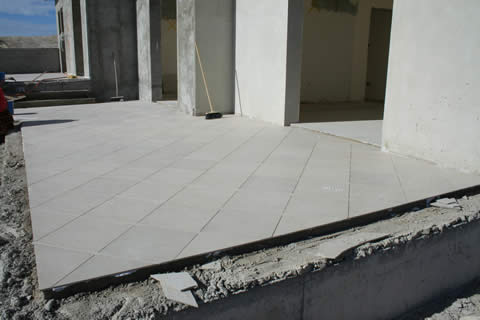

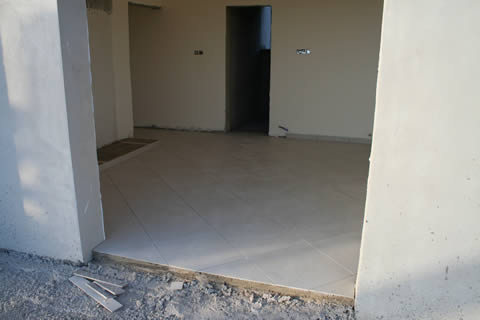

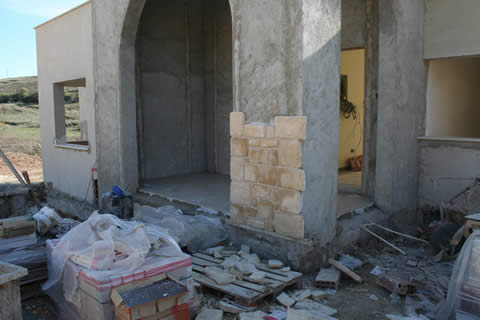

Start of stone facing around the porch.
The porch has also been tiled.
|
|
|

|
|
29 November 2008
The veranda outside the bedroom has been tiled.
|
|
|

|
|
29 November 2008
The main covered veranda has been tiled.
The concrete pillars at the end which will hold up the roof will be faced
with stone.
|
|
|

|
|
29 November 2008
The steps down to the kitchen.
|
|
|
|
|
